EME 05 Activities of planning

Activities of planning

Using Software Packages to Plan a Project

  • yes
    • Very large projects
    • Distributed teams
    • Extensive use of vendors and contractors
  • no
    • Small projects
    • Short duration project increments
    • Adds too much non-value-added work
    • Frequent scope and requirements change

Project Planning Tools

  • Sticky notes (assorted colors)
  • Marking pens (assorted colors)
  • Plenty of whiteboard space

Kanban(看板):An agile method of software process
看板法简介

The JPPS Meeting Components

  • Attendees

    Facilitator
    Project manager
    Another project manager
    JPP consultant
    Technographer
    Core project team
    Client representative
    Resource managers
    Project champion
    Functional managers
    Process owner

  • Facilities
  • Equipment
  • Agenda

    Session #1: Negotiate the COS, Build the RBS
    Session #2: Write the POS
    Session #3

    • Part 1: Kick-off
    • Part 2: Working session.
  • Deliverables
  • Project Proposal

Planning Session Activities

  • Review the POS for clarity

  • Create Work Breakdown Structure (WBS)

  • Estimate task duration and resource needs

  • Construct project network diagram

  • Determine critical path

  • Revise and approve project schedule

  • Finalize resource schedule

  • Gain consensus on the project plan

WBS

Definition of the WBS

The Work Breakdown Structure (WBS) is a hierarchical description of all of the work that must be done to meet the needs of the client.

Generating the WBS

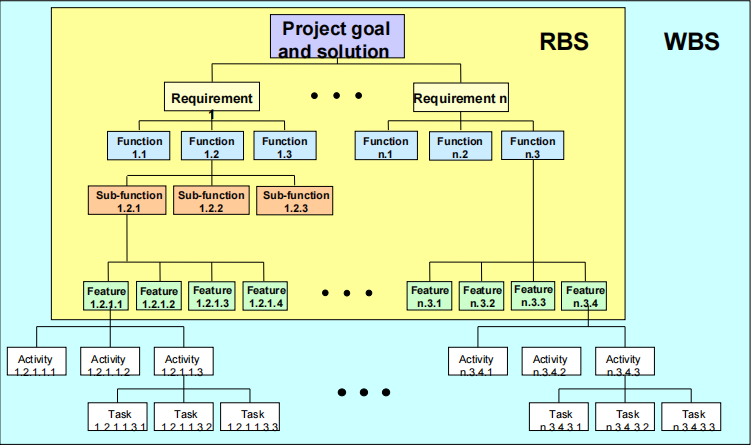

  • Converting the RBS to the WBS (RBS is a subset of the WBS)
  • Top-Down Approach
  • Bottom-Up Approach

WBS Completion Criteria

  • Status and completion are measurable

  • The activity is bounded

  • The activity has a deliverable

  • Time and cost are easily estimated

  • Activity duration is within acceptable limits

  • Work assignments are independent

Generating the WBS

Estimate

Estimate Task Duration or Task Labor

  • Estimate duration to build the schedule and determine when the project will be completed.
  • Estimate labor when you have to contain expenses within a budget

Six Methods for Estimating Task Duration

  • Extrapolating based on similarity to other activities
  • Studying historical data
  • Seeking expert advice
  • Applying the Delphi Technique (next two charts)
  • Applying the Three-point technique (next two charts) :

    E = (O + P + 4M)/6
    O: Optimistic P: Pessimistic M: Most Likely

  • Applying the Wide-band Delphi technique

Estimating Resource Requirements

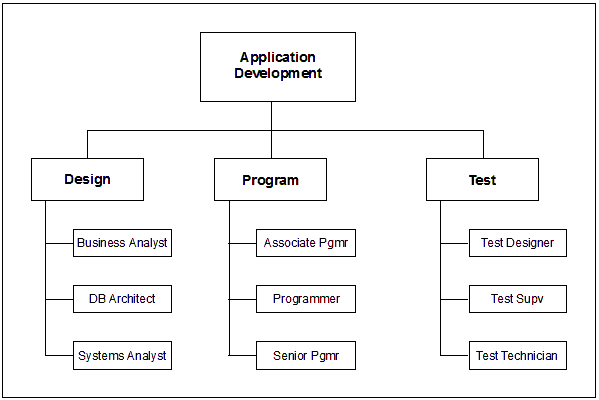

Resource Organizational Structure

Network-based Scheduling

  • Gantt Charts
  • Task on the Arrow
  • Task on the node format

critical path calculation

Node Definition

task node

ES(最早开始) Duration(周期) EF (最早完成)
ID Activity description
LS(最迟开始) SLACK(缓冲期) LF (最迟完成)

Dependency Relationships

Paths Through the Network

  • The Forward Pass – Early Schedule

    ES + duration – 1 = EF

  • Backward Pass – Late Schedule

    LF - duration + 1 = LS

Slack Time

Slack= LF - (ES + duration)

  • Total Slack: Time that a task can be delayed without
    impacting the early schedule of the project
  • Free Slack: Time a task can be delayed without
    impacting the early schedule of its successor tasks.
